Below is how our workflow changed over the course of the past year. I worked closely with the director of the land department to screen different software systems and develope a process that suited our needs, saved time, and money.

Problem, Solution, Results

Introduction

Solar projects require differ from traditional development projects due to the added level of site screening that they must undergo. Not only do these projects require suitable slopes, no wetlands or floodplains, and permitted use within the town code, but they also require capacity on the power lines located adjacent to the site. This greatly limits the amount of sites we can develop on. This added layer of complexity hindered our speed when screening land. Additionally, we used to rely heavily on outside firms to assist in our early development process. This lead to longer lead times and more money down on projects that were not necessarily viable or likely to be approved by the zoning board.

Problem

How can we streamline our development process while lowering upfront capital costs to mitigate risk in early stage projects?

Solution Summary

We leveraged publicly available datasets to do the majority of our land screening in-house without leaving the office. We researched a multitude of software systems to create a structured development pipeline that produced accurate concept plans that could be presented to township planning boards, investors, and civil engineers for further analysis.

Results

Previous workflow:

Workflow Example: 15 MW AC Greenfield Site

I preformed the landscreening, topography analysis, and design for this site.

Land Screening

I used a subscription based software check to check the following

Preparing for a Site Walk

In order to assist the civil team with their site walk, I prepare the following

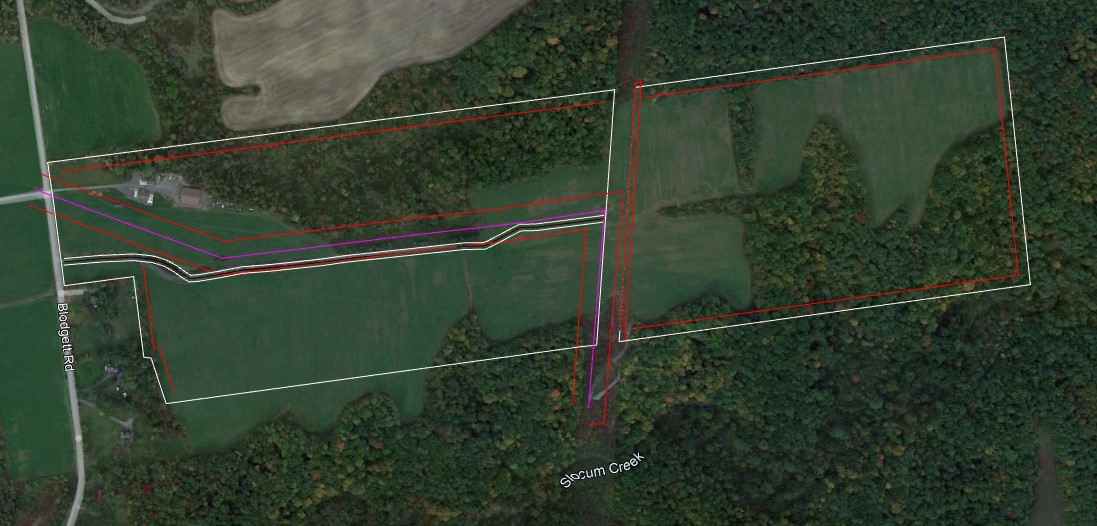

Parcel outline with easements, existing power lines, and roadway

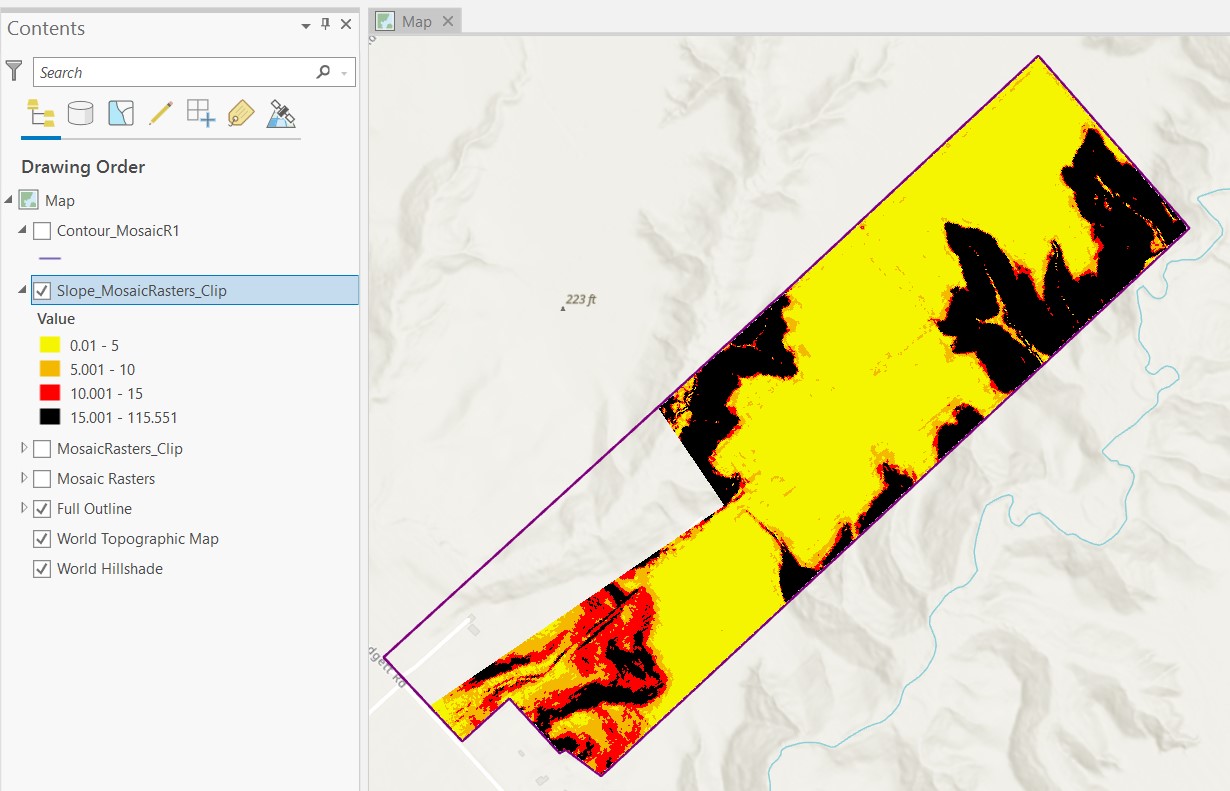

ArcGIS slope analysis from LIDAR data

Site Design

Once the land has been screened, we have established site control, and walked the site (optional at this stage), the site is ready for a design.
